Auckland underground
The need for improved Auckland public transport has occupied civic minds for decades. Archives New Zealand holds reports and plans produced from the 1920s to the 1970s, including photographs of buildings potentially threatened by the construction of underground rail lines. These can be viewed on request in the reading room at our Auckland branch.
1920s: Auckland Morningside deviation
Talk of an underground rail system for Auckland started in the 1920s. An underground rail link known as the Auckland Morningside deviation was proposed.
In 1928 and 1929, detailed plans were drawn up for the route. It began on the main trunk line station on Beach Road on Auckland’s waterfront, travelling underneath the central business district to Morningside on the North-Western route to Kumeū. The cost of the tunnel was estimated to be £440,000.
Search for files that refer to the Auckland Morningside deviation (Item code: R26181488)

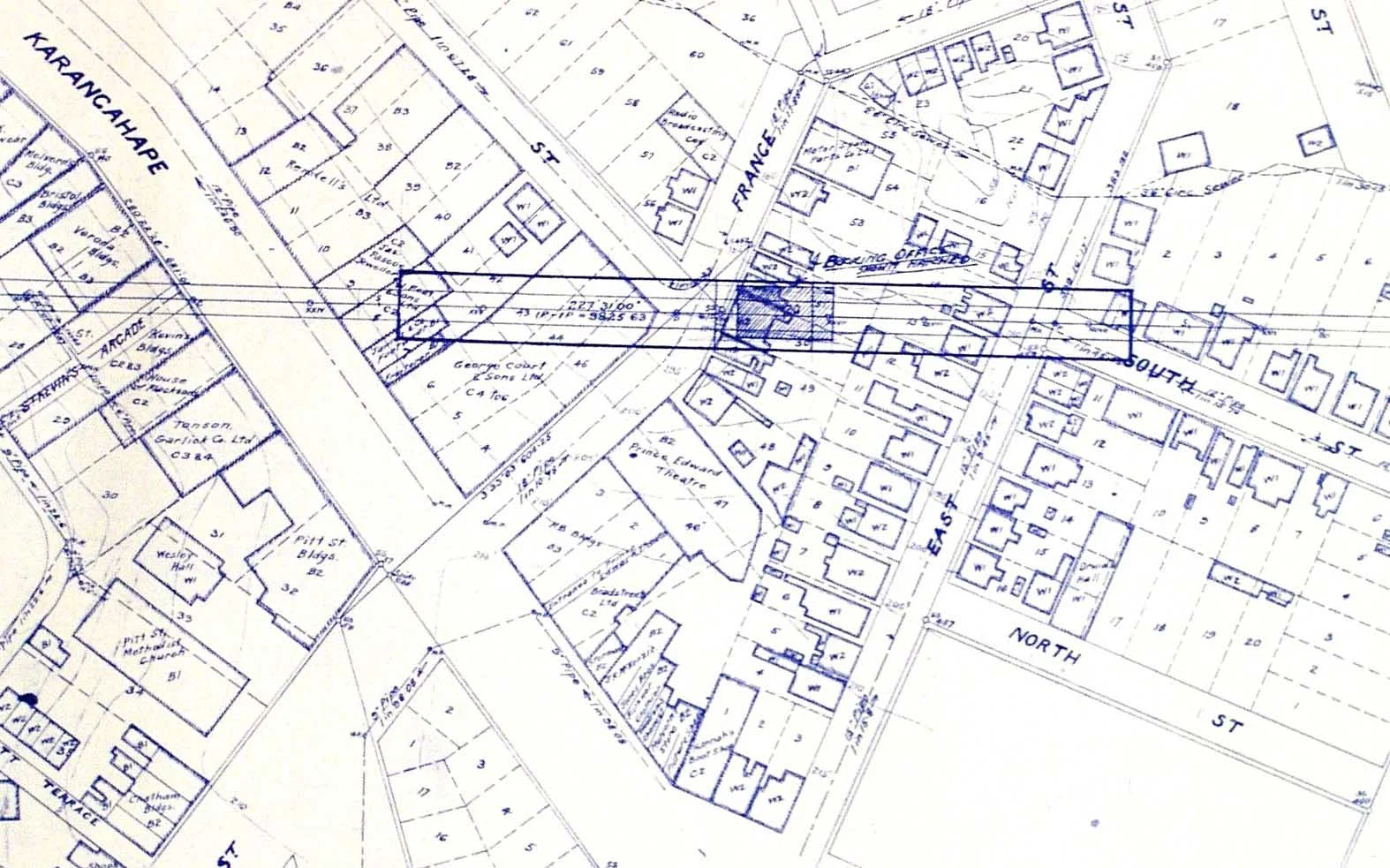

Plan detail showing proposed underground station beneath France Street plan, 5 February 1929.
1940s: The Halcrow & Thomas report
In the 1940s, the Ministry of Works revisited Auckland’s underground rail ambitions, developing a comprehensive transport plan that refined the earlier Morningside proposal. The report recommended railway electrification, an underground city loop and a western suburban loop.
While Wellington’s rail network was eventually electrified, Auckland’s plans remained on the drawing board until 1949, when the government commissioned a report into Auckland’s suburban rail network. The 1949 Halcrow & Thomas report recommended electrification and the building of the Morningside underground link.
Search for files related to Halcrow & Thomas Report, 1949 (Item code: R22457799)
1950s: The Master Transport Plan
At first, the priority for railway construction under the plan was the Auckland Morningside deviation. This would take a similar, but not identical, route to the plan developed in 1929.
A map showing the proposed route for Morningside deviation from the 1956 Master Transportation Plan, p.157.

A map showing average daily traffic flows in Auckland, 1930-1954. From the 1956 Master Transport Plan, pp. 94-95.
To prepare for construction, during 1952 and 1953 an investigation of buildings along the proposed route was undertaken. Building condition, type of foundation and building value were noted. This investigation, including photos of buildings along the proposed route, can be found in Archives New Zealand.
But in 1955, the Auckland Regional Planning Authority’s final Master Transport Plan for Metropolitan Auckland recommended investing in motorways rather than railway. Auckland’s electric trams were ended in 1956.
-
Click to expandSouth British Insurance CompanyBABJ A680/1 /1 [sch.39]1953, corner of Shortland and High Streets, built in 1928
Click to expandSouth British Insurance CompanyBABJ A680/1 /1 [sch.39]1953, corner of Shortland and High Streets, built in 1928
-
Click to expandSharland's ChemistsBABJ A680/1 /1 [sch.41]1953, with a tea room on the first floor Shortland Street, built about 1910
Click to expandSharland's ChemistsBABJ A680/1 /1 [sch.41]1953, with a tea room on the first floor Shortland Street, built about 1910
-
Click to expandGordon's BuildingBABJ A680/1/1 [sch.45]1953, corner of Queen and Swanson Streets
Click to expandGordon's BuildingBABJ A680/1/1 [sch.45]1953, corner of Queen and Swanson Streets
-
Click to expandAlbert HouseBABJ A680/1/1 [sch.60]1953, 44 Albert Street, built about 1865. A small tobacco kiosk squeezed between Gordon Vacuum Break Milkers Ltd and Ridd "Full Action Milkers"
Click to expandAlbert HouseBABJ A680/1/1 [sch.60]1953, 44 Albert Street, built about 1865. A small tobacco kiosk squeezed between Gordon Vacuum Break Milkers Ltd and Ridd "Full Action Milkers"
-
Click to expandEJ Kelley & CoBABJ A680/1/2 [sch.68]1953, iron and brass foundry, 51 Kingston Street
Click to expandEJ Kelley & CoBABJ A680/1/2 [sch.68]1953, iron and brass foundry, 51 Kingston Street
-
Click to expand60 - 62 Greys AvenueBABJ A680/1/3 [sch.122]1953, residences, built in 1912
Click to expand60 - 62 Greys AvenueBABJ A680/1/3 [sch.122]1953, residences, built in 1912
-
Click to expandNaval and Family HotelBABJ A680/1/3 [sch.145]1953, corner of Pitt Street and Karangahape Road
Click to expandNaval and Family HotelBABJ A680/1/3 [sch.145]1953, corner of Pitt Street and Karangahape Road
-
Click to expandPolynesian Dance HallBABJ A680/1/3 [sch.146]1953 149 - 151 Karangahape Road
Click to expandPolynesian Dance HallBABJ A680/1/3 [sch.146]1953 149 - 151 Karangahape Road
1960s and 1970s: The Auckland Rapid Transit project
Traffic congestion continued to be a problem during the 1960s, despite the building of new motorways and the opening of the Auckland Harbour Bridge in 1959.
In 1963, the Auckland Regional Authority commissioned a report from San Francisco transport engineering firm De Leuw Cather & Co. It promoted motorways, and also a coordinated bus and train network.
In 1968, an Auckland Rapid Transit (ART) committee was formed to investigate railway solutions to Auckland’s transport problems. Detailed planning was done and investigations completed.

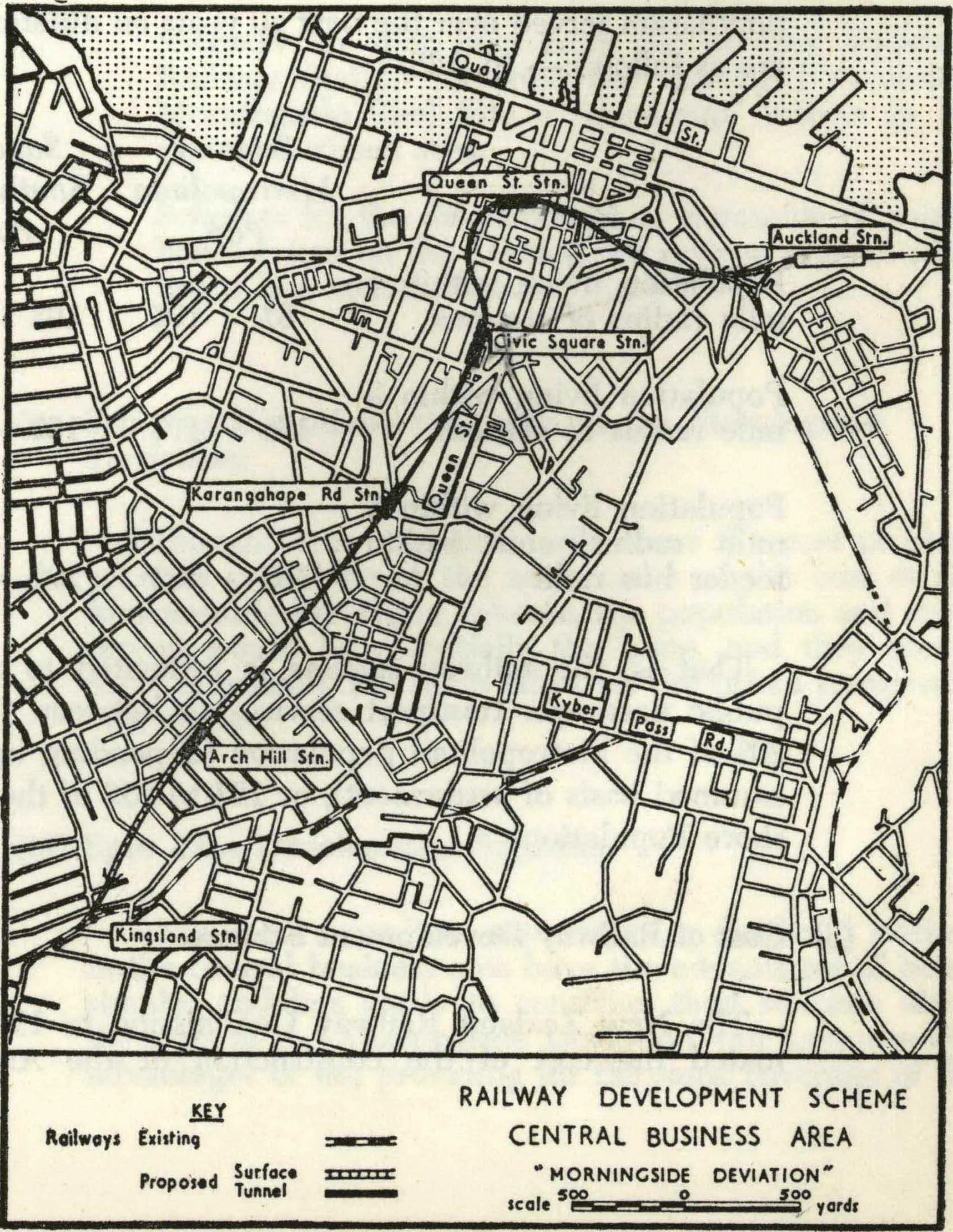

It was decided that the priority was for a city underground line to be constructed in two phases: Auckland mainline station to the Civic Centre first, then under Karangahape Road to Newmarket (a similar route to the Auckland Morningside deviation).
Search for files related to the Auckland Rapid Transit project, 1955 to 1973 (Item code: R262008)

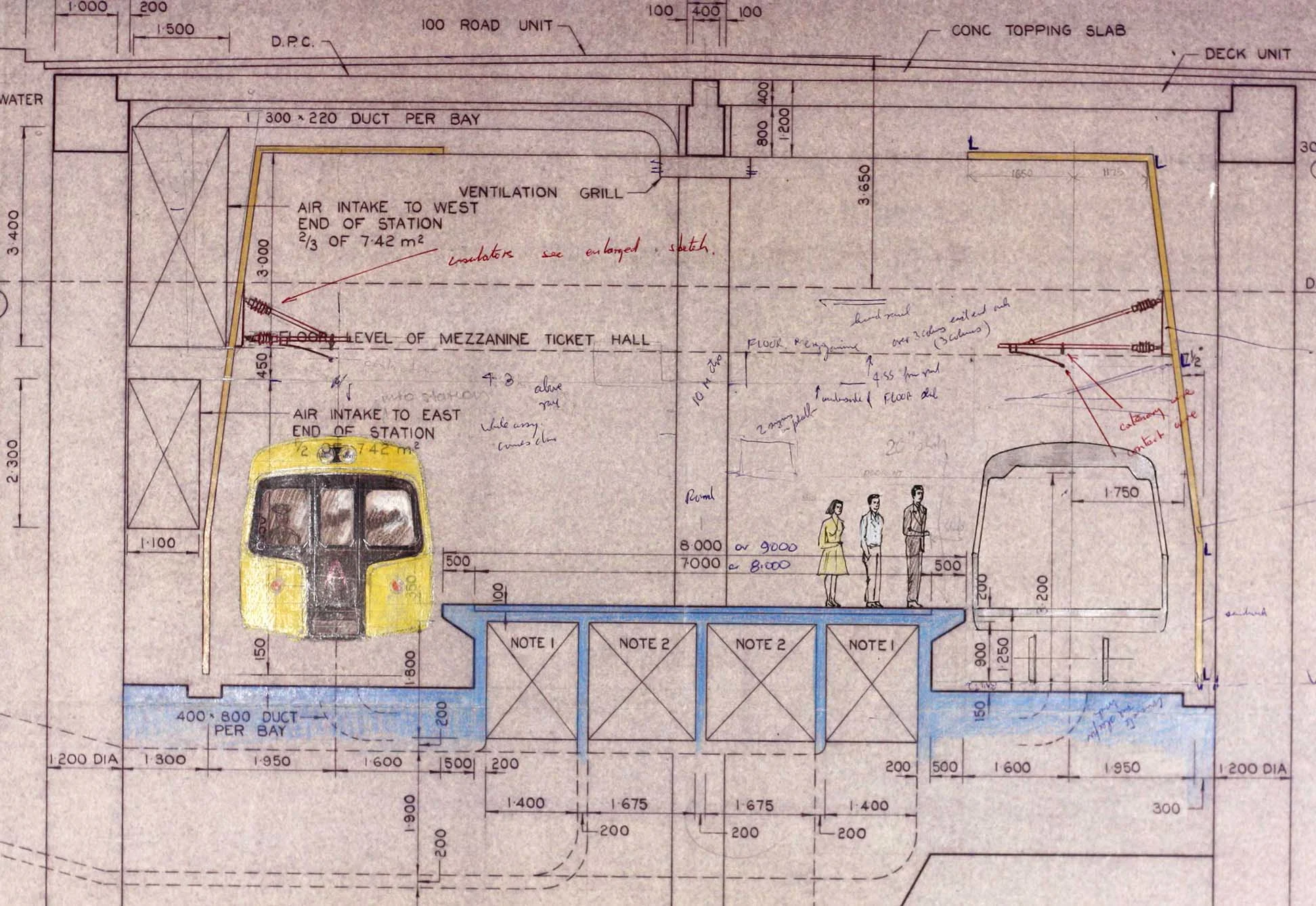

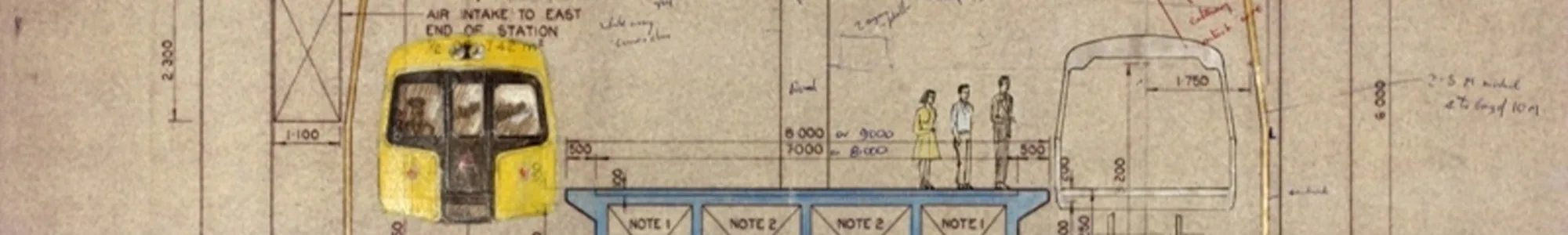

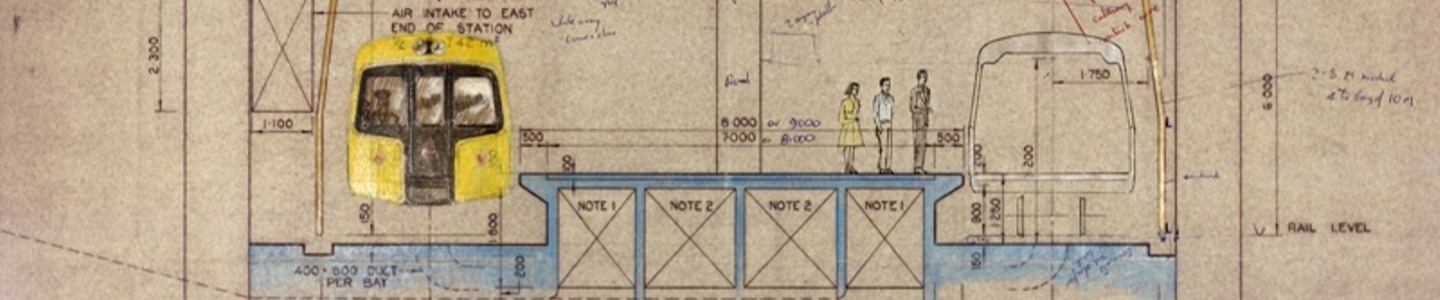

c.1970. This shows the planned city link, as well as the airport link.

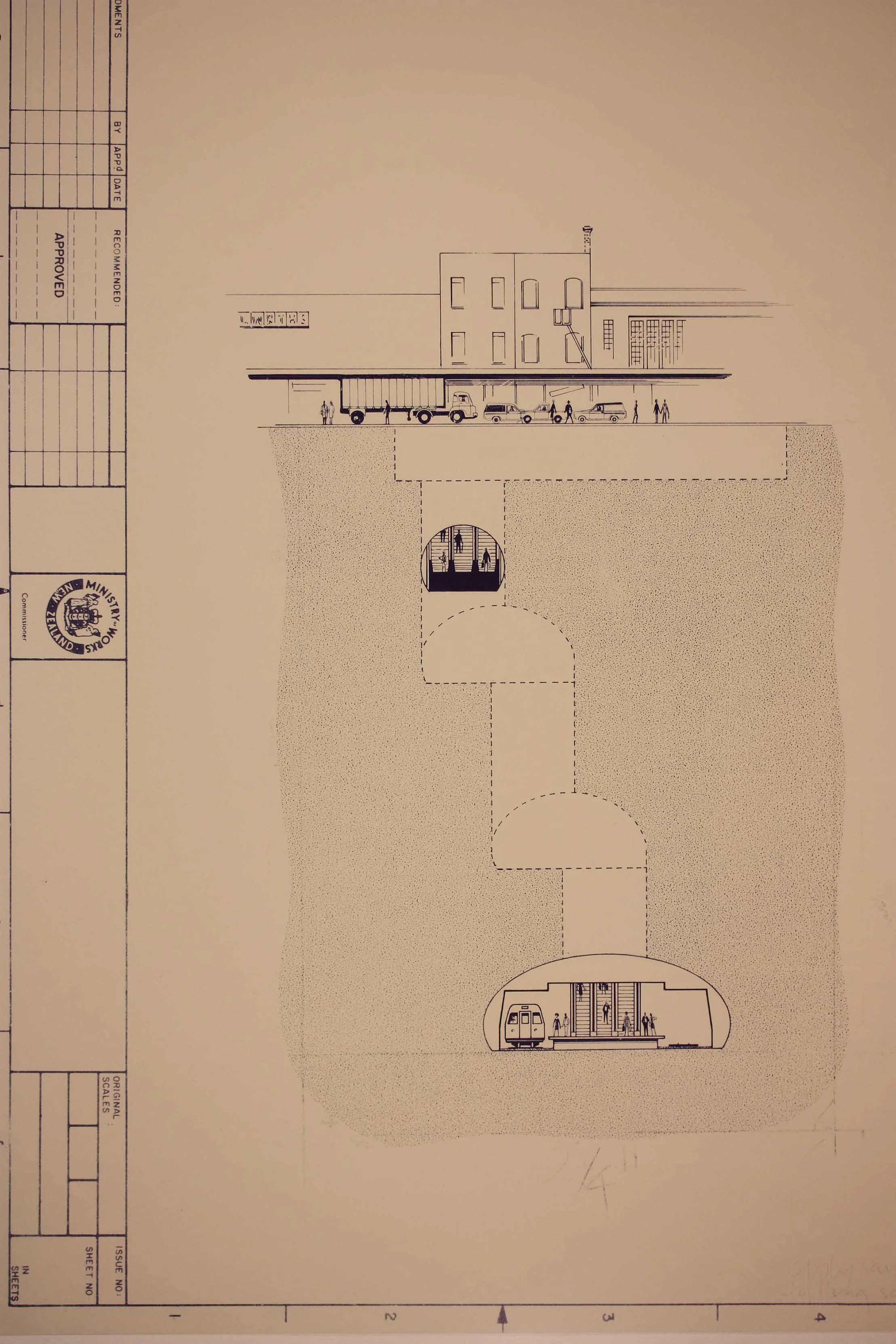

Diagram showing proposed underground station, 1969.
Preliminary carcase plans, cross-section (detail) c.1974

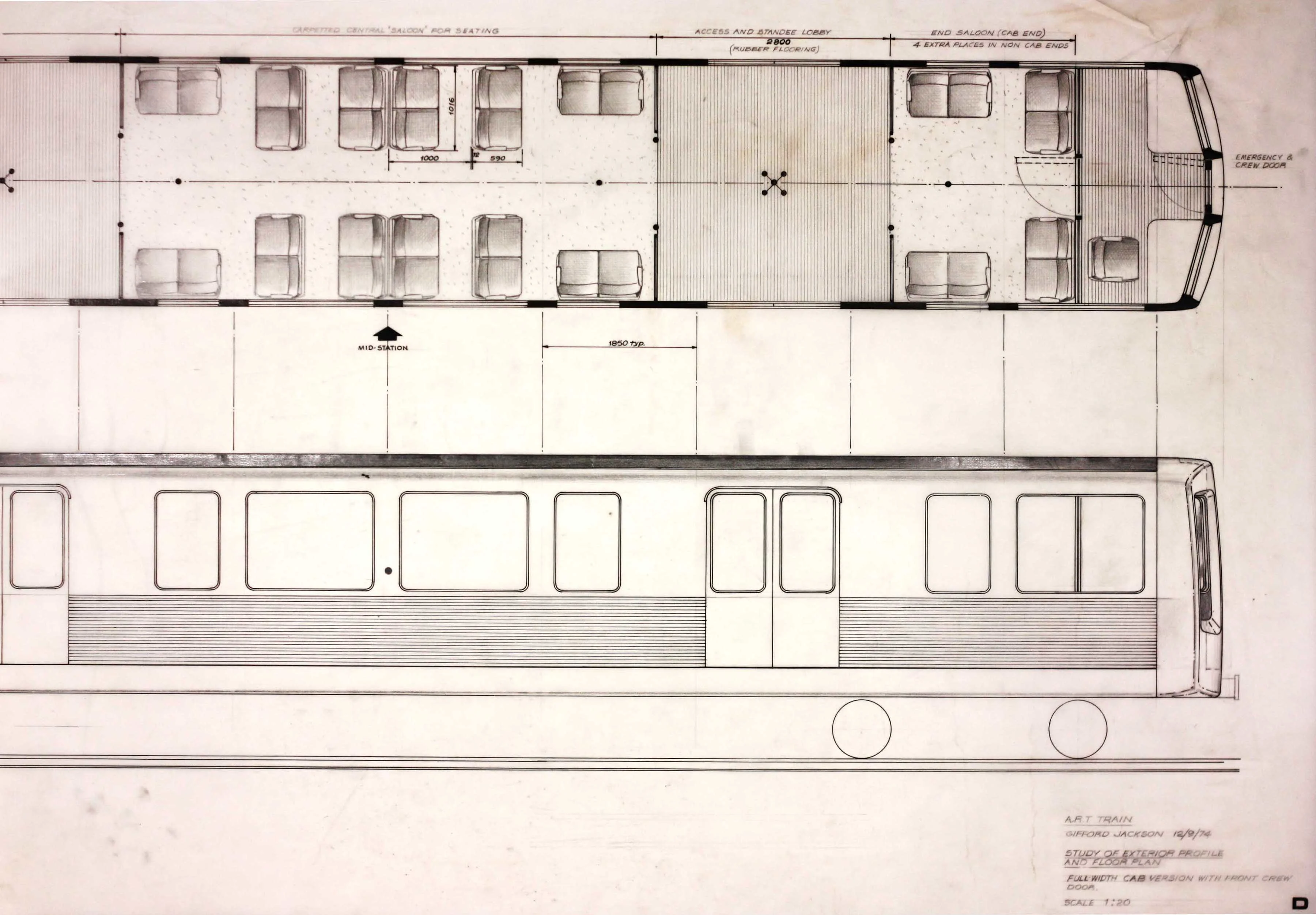

Train floor plan and side elevation (detail) 1974
Again, as part of the investigations, photographs were taken of some of the buildings along this route in 1973. There would be a system of bus services linked to the rail services; trains would run with a minimum off-peak frequency of ten minutes; and fares would be based on a zone structure, with ticket transfer between bus and rail.
But ART was disbanded on 31 March 1976, and plans for underground rail were stopped. It wasn’t until the 1990s that the push for electrification and for expansion of a passenger rail network was revived, this time by the Auckland Regional Authority.
-
Click to expandStation HotelBABJ A680/19/81Beach Road c.1973
Click to expandStation HotelBABJ A680/19/81Beach Road c.1973
-
Click to expandDilworth BuildingBABJ A680/19/70 no.76Corner of Queen Street and Customs Street East, c.1973
Click to expandDilworth BuildingBABJ A680/19/70 no.76Corner of Queen Street and Customs Street East, c.1973
-
Click to expandCustom HouseBABJ A680/19/70 no.14Albert Street frontage, c.1973
Click to expandCustom HouseBABJ A680/19/70 no.14Albert Street frontage, c.1973
-
Click to expandT & G BuildingBABJ A680/19/70 no.3from Bledisloe Street, c.1973
Click to expandT & G BuildingBABJ A680/19/70 no.3from Bledisloe Street, c.1973
-
Click to expandAuckland Town HallBABJ A680/19/70 no.7During excavation for building of civic underground car park c.1973
Click to expandAuckland Town HallBABJ A680/19/70 no.7During excavation for building of civic underground car park c.1973
-
Click to expandCivic TheatreBABJ A680/19/70 no.14Corner of Queen and Wellesley Streets, c.1973
Click to expandCivic TheatreBABJ A680/19/70 no.14Corner of Queen and Wellesley Streets, c.1973
-
Click to expandSmith and CaugheyBABJ A680/19/70 no.2Department store, corner of Elliot and Wellesley Streets, c.1973
Click to expandSmith and CaugheyBABJ A680/19/70 no.2Department store, corner of Elliot and Wellesley Streets, c.1973
-
Click to expandWaterloo QuadrantBABJ A680/19/70With Fisher International building in the background, c.1973
Click to expandWaterloo QuadrantBABJ A680/19/70With Fisher International building in the background, c.1973
21st century: The City Rail Link project
Eventually, the City Rail Link project picked up the work started more than a century ago. One day, the records for the project (2015 to 2026) will be transferred to Archives New Zealand and the Auckland underground story will continue.
What will Tāmaki Makaurau’s underground transport network look like by the end of the 21st century?
